Wynn Al Marjan Island — the integrated resort featuring a casino in Ras Al Khaimah — is pressing ahead toward a Q1 2027 opening, despite facing headwinds from instability in the Middle East region.
For real estate investors, the key questions are: ① Has construction truly continued without stopping? ② Has recruitment begun in preparation for operations? ③ Are the finances and management structure in order?
In this article, we break down the current status of the Ras Al Khaimah casino project.
Is the Ras Al Khaimah Casino Project Moving Forward Amid Regional Tensions?

In March 2026, Wynn Resorts announced that while the project had experienced a temporary pause due to the impact of Middle East tensions — including regional instability, logistics through the Strait of Hormuz, and operational disruptions at UAE airports and airspace — construction has since resumed.
In its press release, the company explained that it is continuing work on-site with employee safety as the top priority, while maintaining close communication with the government.
Geopolitical risk has not disappeared entirely. However, construction has resumed with the safety of on-site workers as the primary concern.
Current Progress on the Ras Al Khaimah Casino Project
The project is a large-scale integrated resort featuring a 70-storey hotel tower, 1,530 guest rooms and suites, 22 food and beverage outlets, a theatre, luxury retail, and a marina.

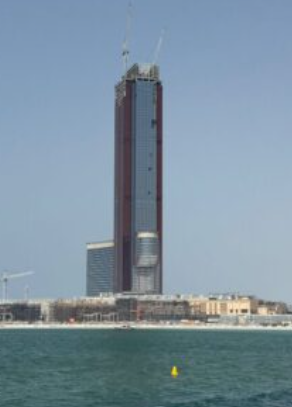

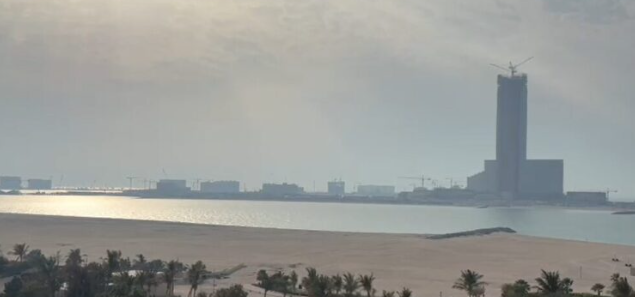

Wynn Al Marjan Island completed the structural topping-out of the hotel tower in Q4 2025 and remains on schedule for an opening in early 2027. Interior fit-out work is currently reported to be underway.
In short, the project is nearing completion, and a Q1 2027 opening appears highly probable.
Has Recruitment Begun Ahead of the Casino Opening?

Source:Wynn Al Marjan Island『FIND JOBS』
Wynn Al Marjan Island has already launched its hiring campaign.
As of February 2026, the resort has hired approximately 2,750 staff, with plans to grow the workforce to around 3,000 employees by the end of 2026.
While headcount stood at just 251 in Q4 2025 — focused primarily on senior executives, senior management, and administrative roles — the strategy has been to bring in leadership and operations managers first, followed by large-scale hiring and training of frontline staff.
This demonstrates that operational frameworks are being firmly established ahead of opening.
Roles Being Recruited
Wynn Al Marjan Island has posted over 100 job listings spanning a wide range of functions, including casino operations, hotel operations, food and beverage, entertainment, finance, IT, legal, and retail. Notably, some positions represent the first casino management roles in the GCC region.
Specific roles include Casino Manager and Pit Manager for table games operations, Administrative Assistant within the casino division, Executive Chef for F&B, Head of Nightlife Operations, and Head of Floral Operations.
Salary figures are not disclosed in most listings; however, the resort is offering an attractive package including annual leave, medical insurance, life insurance, incentive schemes, and additional benefits — a clear effort to compete for top talent.
Given the intense global competition for professionals in casino operations, VIP services, luxury F&B, entertainment, and luxury hotel management, the strength of Wynn’s compensation and benefits package signals just how seriously the company is taking its opening preparations.
Funding for Wynn Al Marjan Island
Wynn Resorts has committed substantial financial resources to this project.
According to Wynn Resorts’ Q4 2025 earnings results, the company contributed USD 79.2 million in Q4 2025 alone to the joint venture — in which it holds a 40% stake — bringing its cumulative total investment to USD 914.2 million.
Key Considerations for Real Estate Investors Evaluating the Ras Al Khaimah Casino Project
Of course, this does not mean the project is without risk. Ras Al Khaimah has been named among potential targets in relation to Iranian threats, so it cannot be declared entirely safe. Investors should remain mindful of risks such as potential delays to the opening timeline and rising construction costs due to logistics disruptions.
That said, the evidence currently available points to the project advancing steadily on all fronts:
- The hotel tower has been topped out structurally
- Wynn continues to maintain its Q1 2027 opening outlook
- Approximately 2,750 staff have been hired
- Recruitment is underway across all key operational areas — gaming, hotel, F&B, IT, legal, and more
- Wynn Resorts has already committed over USD 900 million in cumulative investment
Wynn Bridge Also Under Construction Ahead of the Casino Opening

Construction is also progressing on the Wynn Bridge on Al Marjan Island in Ras Al Khaimah. The bridge will span 548 metres and connect Al Marjan Island to two of the UAE’s major highways — E311 and E611 — via Wynn Boulevard.
Wynn Resorts has officially announced that the bridge is expected to be completed in the second half of 2026, improving access to Al Marjan Island from Dubai, Sharjah, and Ajman.
Conclusion
Wynn Al Marjan Island — including Ras Al Khaimah’s casino — is advancing steadily toward its opening, even as it navigates the challenges posed by the regional geopolitical environment.
What matters most is that all three critical pillars — construction progress, financial commitment, and talent acquisition — are moving forward in tandem. As such, this project warrants continued attention from investors, not only as the UAE’s first commercial gaming resort, but as a major growth catalyst for Ras Al Khaimah’s tourism, real estate, and employment markets.
If you have any questions about the Ras Al Khaimah casino project, please do not hesitate to contact JCME GROUP.
